Shoring Deep Excavations Along the Existing Foundation

Deep excavations next to existing structures are rarely about digging ! They’re about restraint.

When you remove 8–10 feet of soil beside an active structure, you’re not just creating space for a new foundation - you’re disturbing a stress equilibrium that has existed for decades.

This small case study walks through how we approached a tight urban excavation where:

  • Retained height around 10 feet

  • Existing grade beams and footings were directly adjacent

  • Tiebacks were limited in several directions

  • Sequencing and constructability were just as important as calculations

The system itself wasn’t revolutionary, The thinking behind it is what mattered.

Live Earth Pressure Simulator

➔➔➔
PUSHING HARDER
SURFACE
EXCAVATION BASE
The Engineering Logic:
Select a depth to see the Rankine Pressure Triangle grow. At 10ft, the pressure isn't just double—the total force is 4x greater than at 5ft because the "area" of the triangle grows both deeper and wider.

Step 1: Choosing the Right Shoring System

For this excavation, we selected a soldier pile and lagging system using:

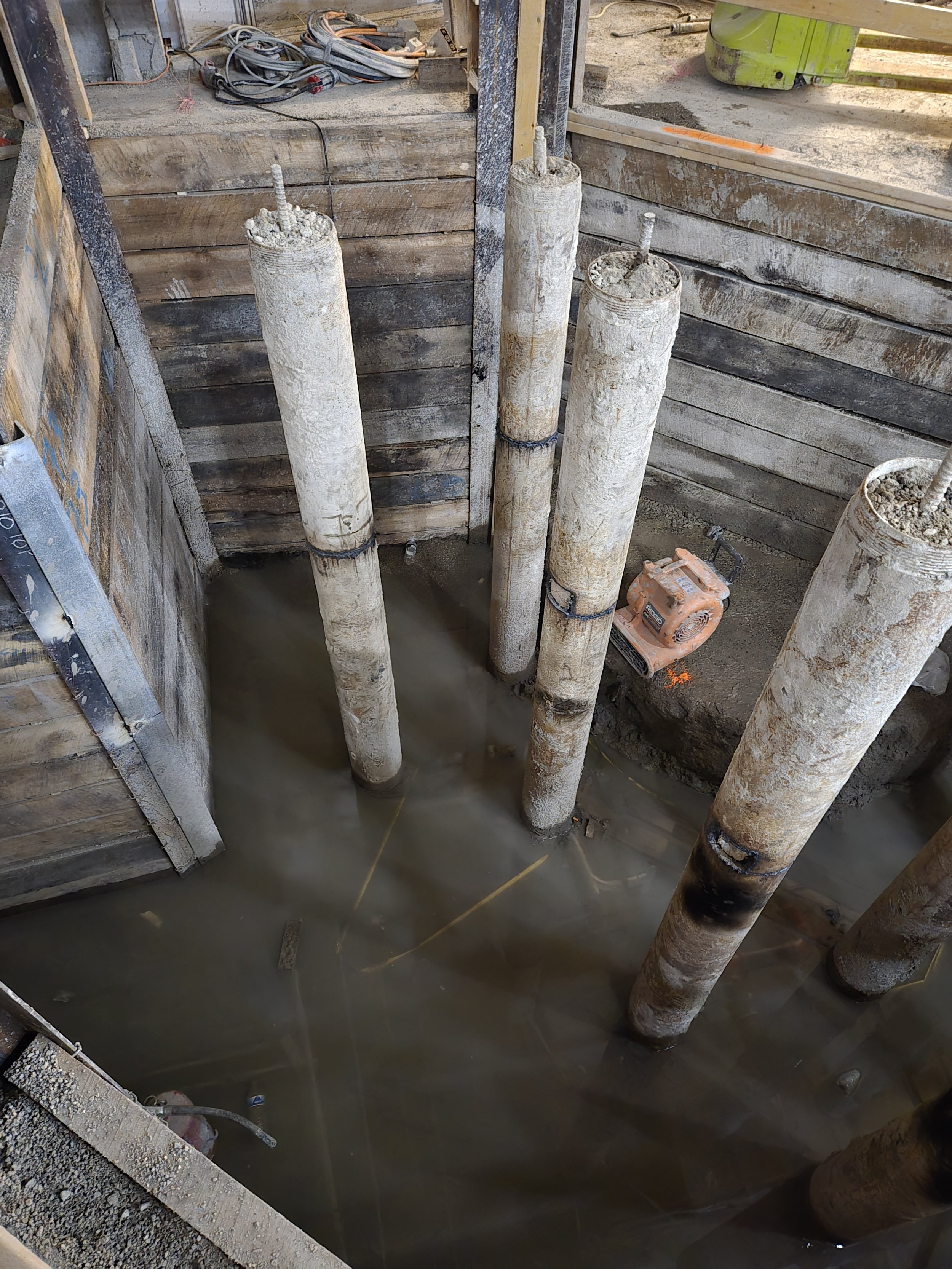

  • W6x15 steel soldier piles

  • Rough-cut hardwood lagging

  • Minimum embedment below excavation bottom

  • Drainage relief between boards

Why soldier piles?

Because they offer:

  • Low vibration installation

  • Flexibility in irregular geometry

  • Predictable staged performance

  • Contractor familiarity

  • Adaptability when field conditions shift

In constrained space, reliability beats novelty.

Shoring System Comparison Matrix

Soldier Piles

Low Vibration
Tight Space
Budget Friendly

Secant Piles

Low Vibration
Tight Space
Budget Friendly

Sheet Piling

Low Vibration
Tight Space
Budget Friendly

Step 2: Embedment Is Not Just a Number

One of the most common misunderstandings in temporary shoring is that embedment is simply “what the calc says.”

It’s not !

Embedment controls:

  • Passive resistance mobilization

  • Rotation control at the toe

  • Overall system stiffness

  • Bracing demand above

The embedment depth here was set to ensure sufficient passive resistance beneath the excavation bottom, not just to prevent failure - but to reduce movement.

Because in these scenarios, movement is the real enemy.

Embedment Depth & Stability

CRITICAL DEFLECTION
PASSIVE RESISTANCE ZONE

Step 3: When Tiebacks Aren’t an Option

In an open site, tiebacks are often the first choice.

But when adjacent structures, utilities, or property constraints prevent anchor installation, the design must adapt.

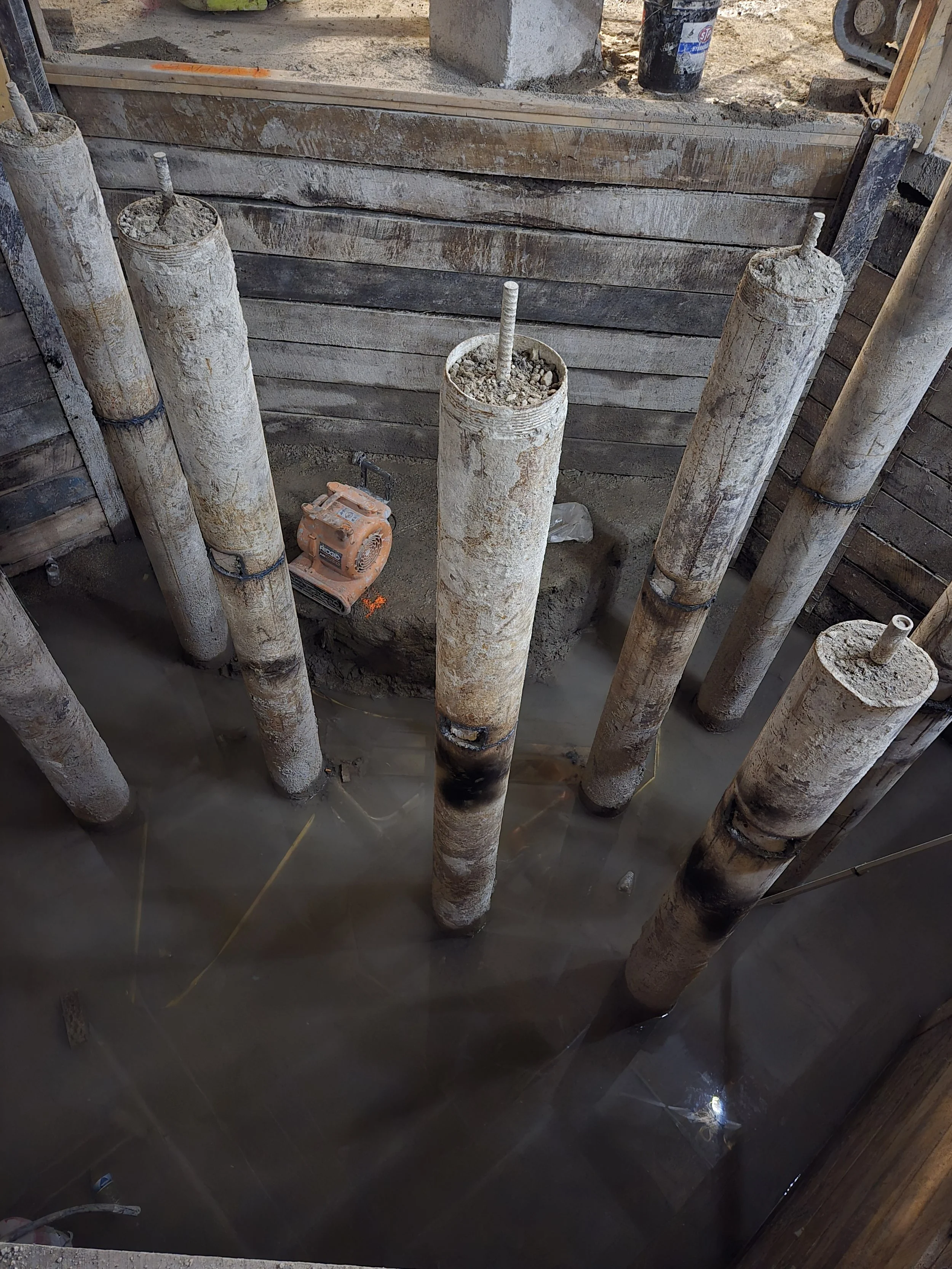

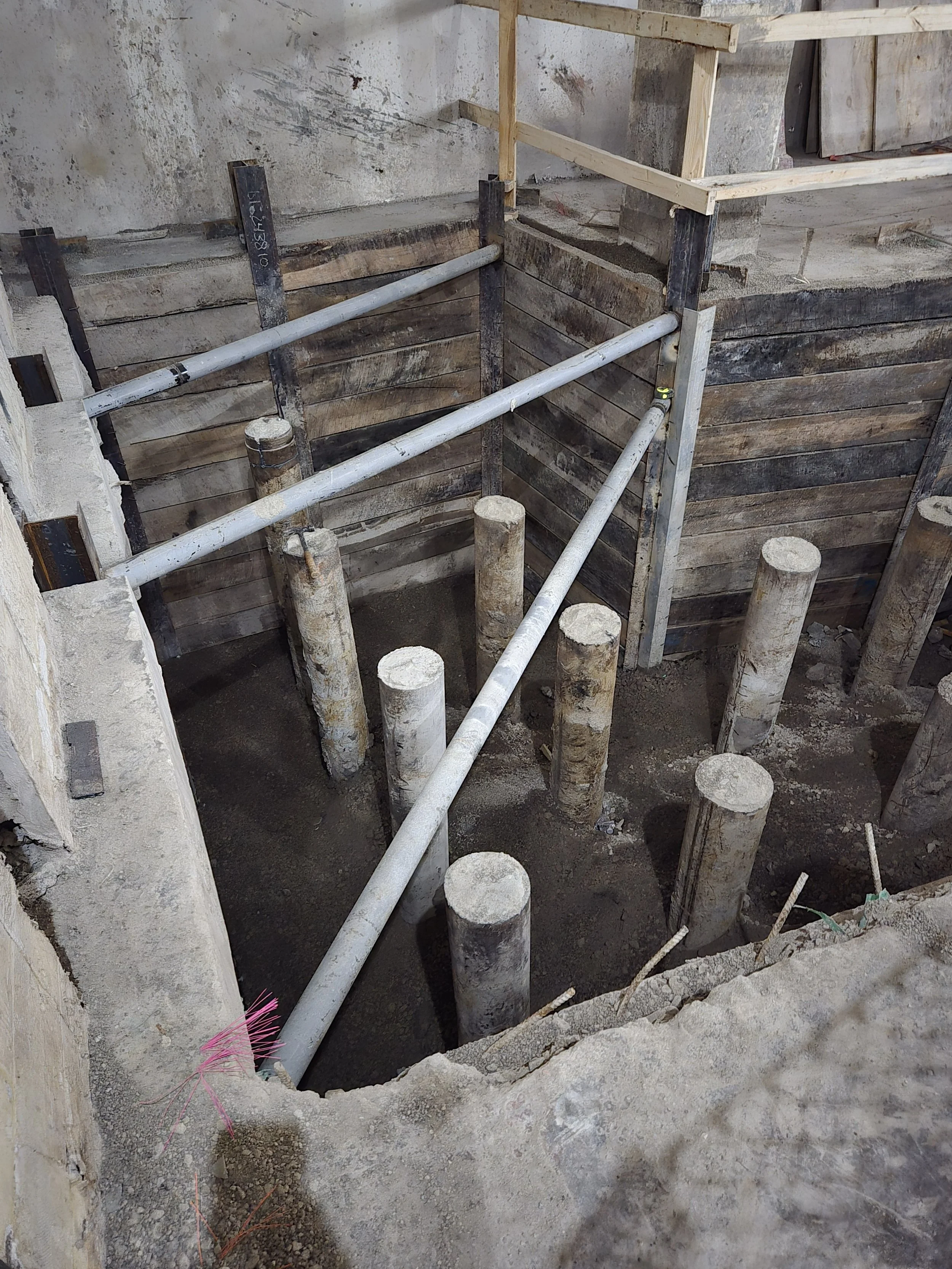

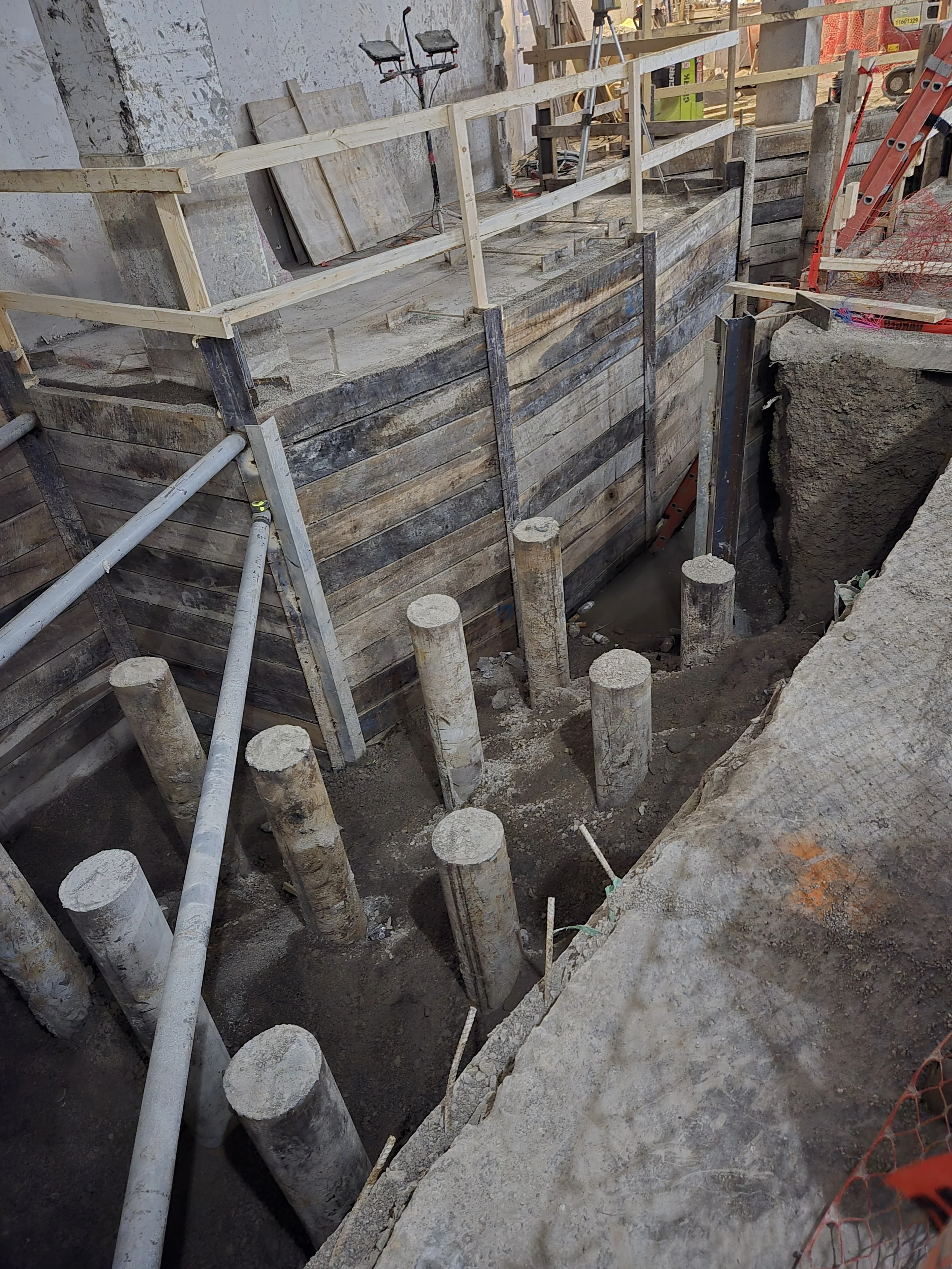

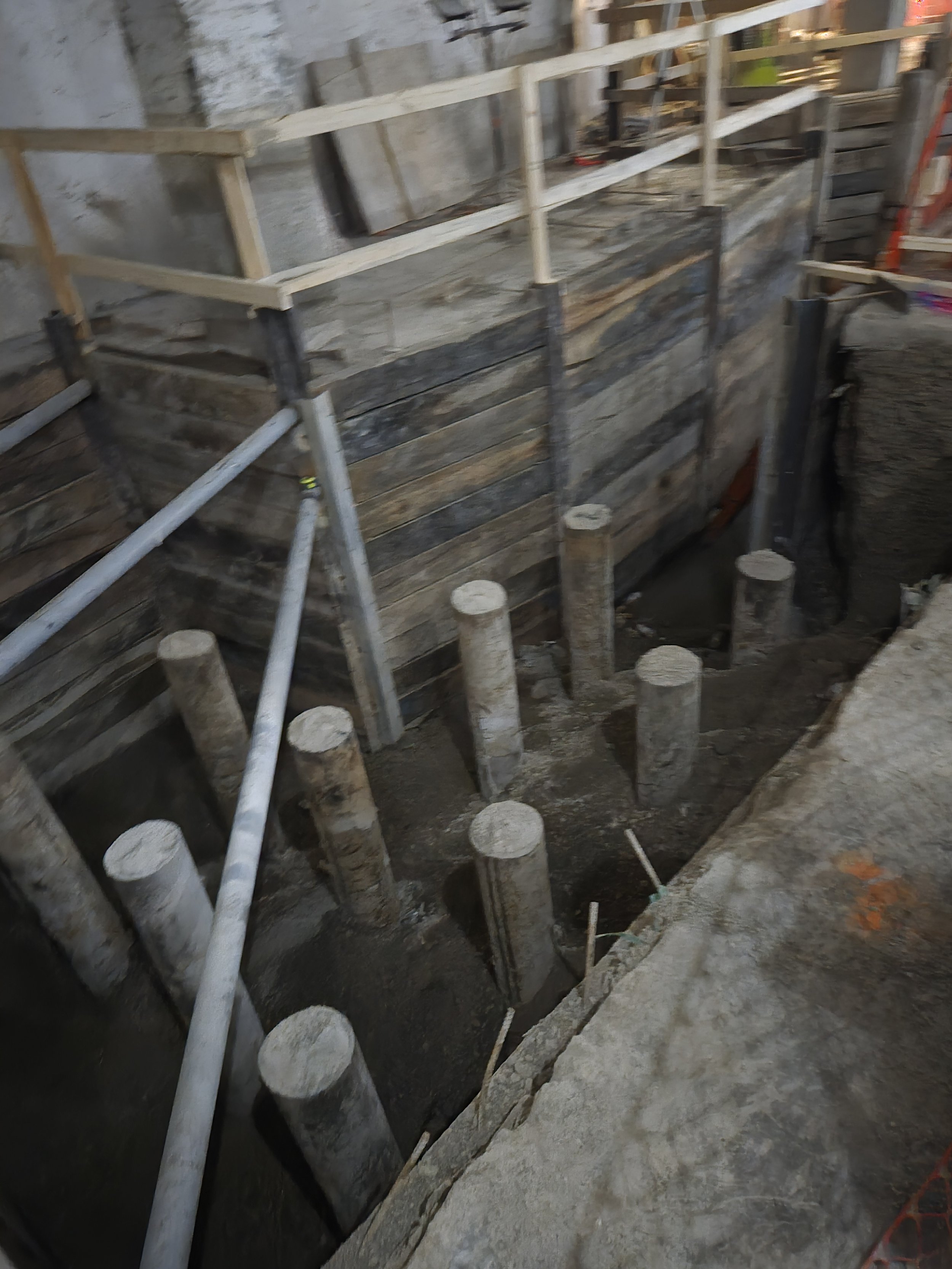

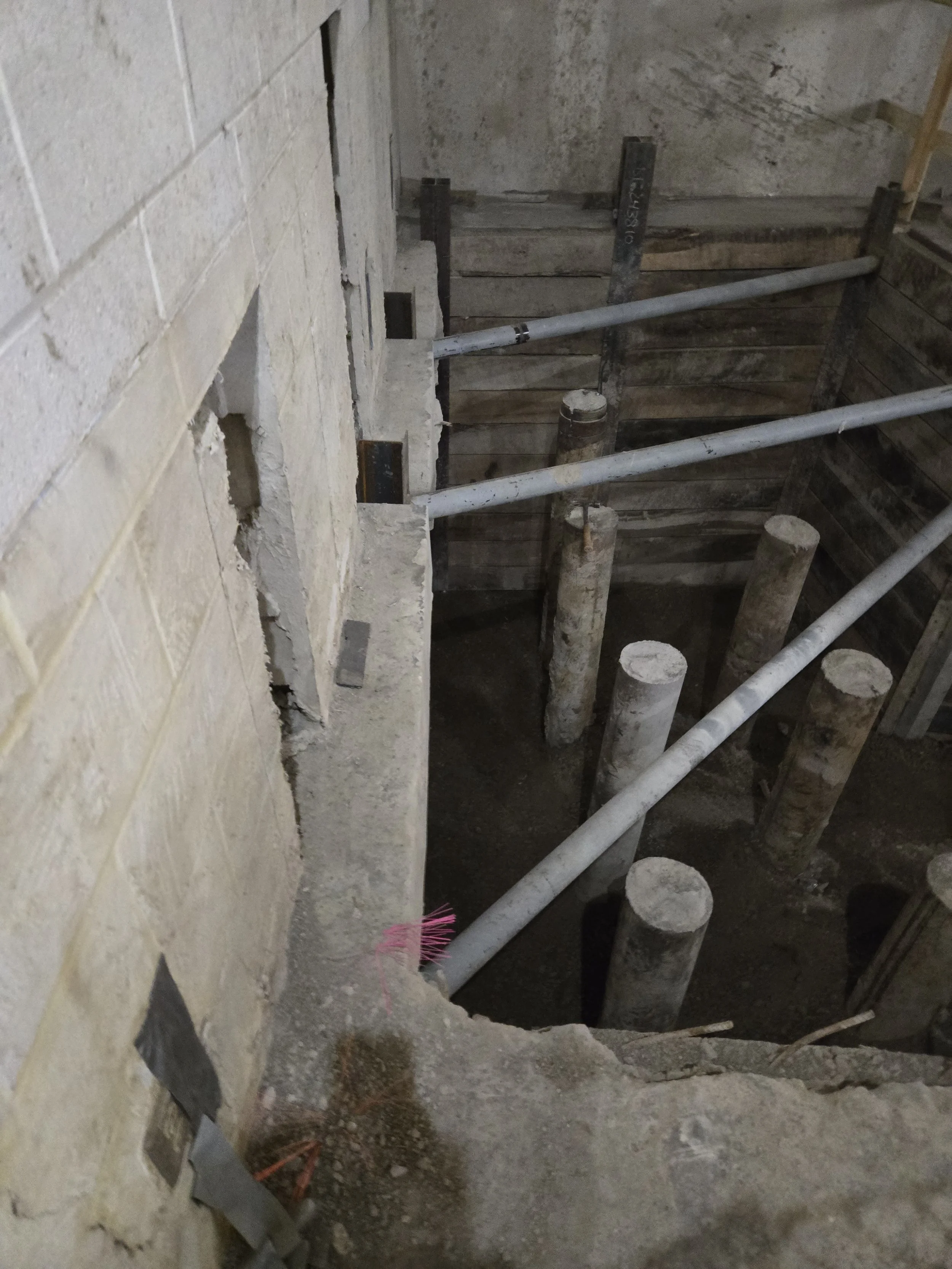

In this case, portions of the excavation required internal pipe bracing instead of tiebacks. The system incorporated:

  • Horizontal pipe braces

  • Angled brace orientations to match geometry changes

  • Welded brace connections centered over the H-pile web

  • Phased installation as excavation progressed

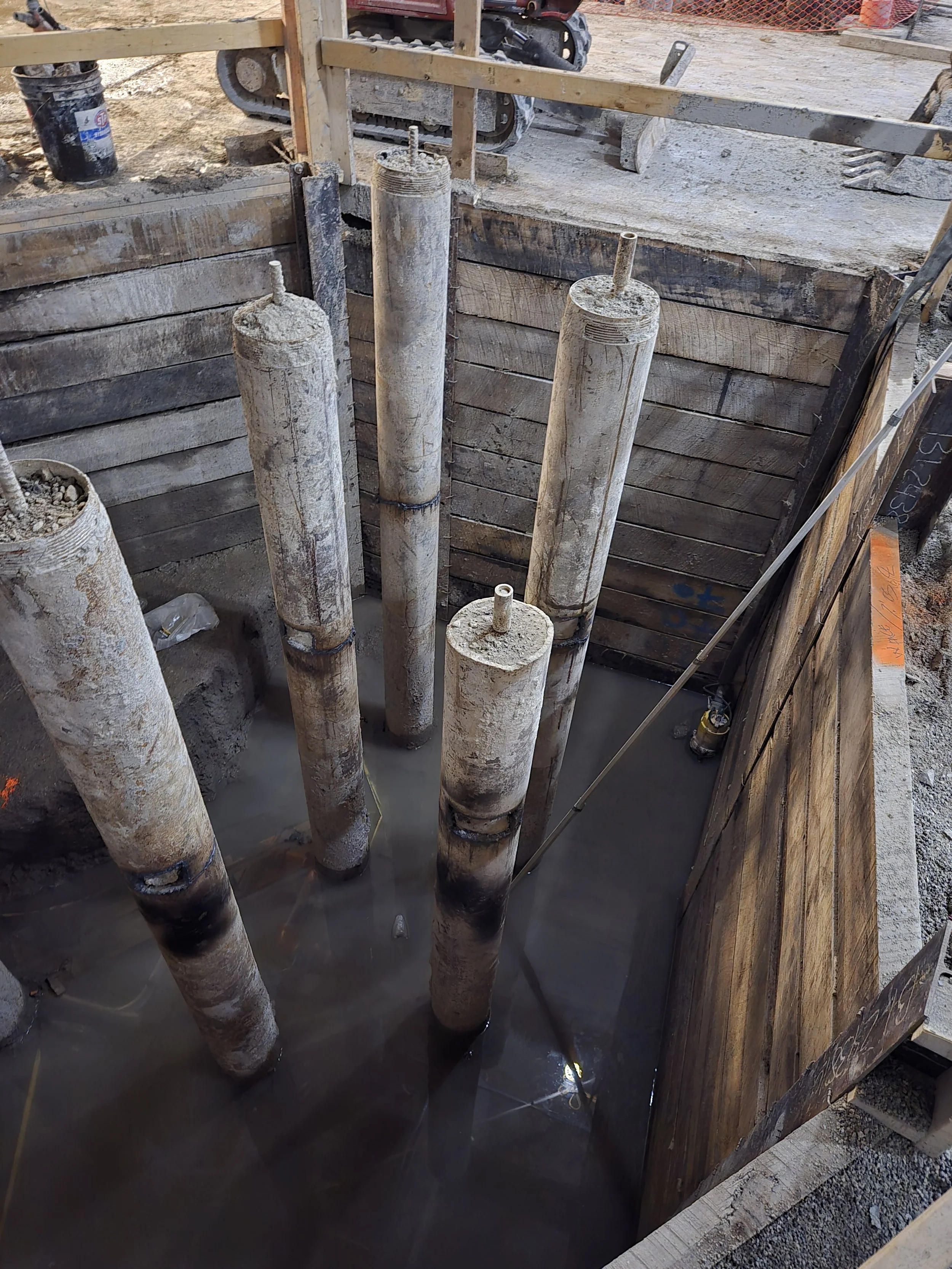

Internal bracing increases structural demand on the soldier piles - but when detailed properly, it creates a stable triangulated system that performs reliably.

The key is sequencing.

Shoring Selection: Tiebacks vs. Bracing

Choose a support system to see site constraints and work-space impacts.

Tieback Anchors Internal Bracing
Property (0' to 40' depth)
⚠️
Utility / Existing Foundation
Tieback Conflict!
Sheet Pile
Excavation (30' Deep)
Obstructed Work Space

Step 4: Sequencing - The Part That’s Rarely Discussed

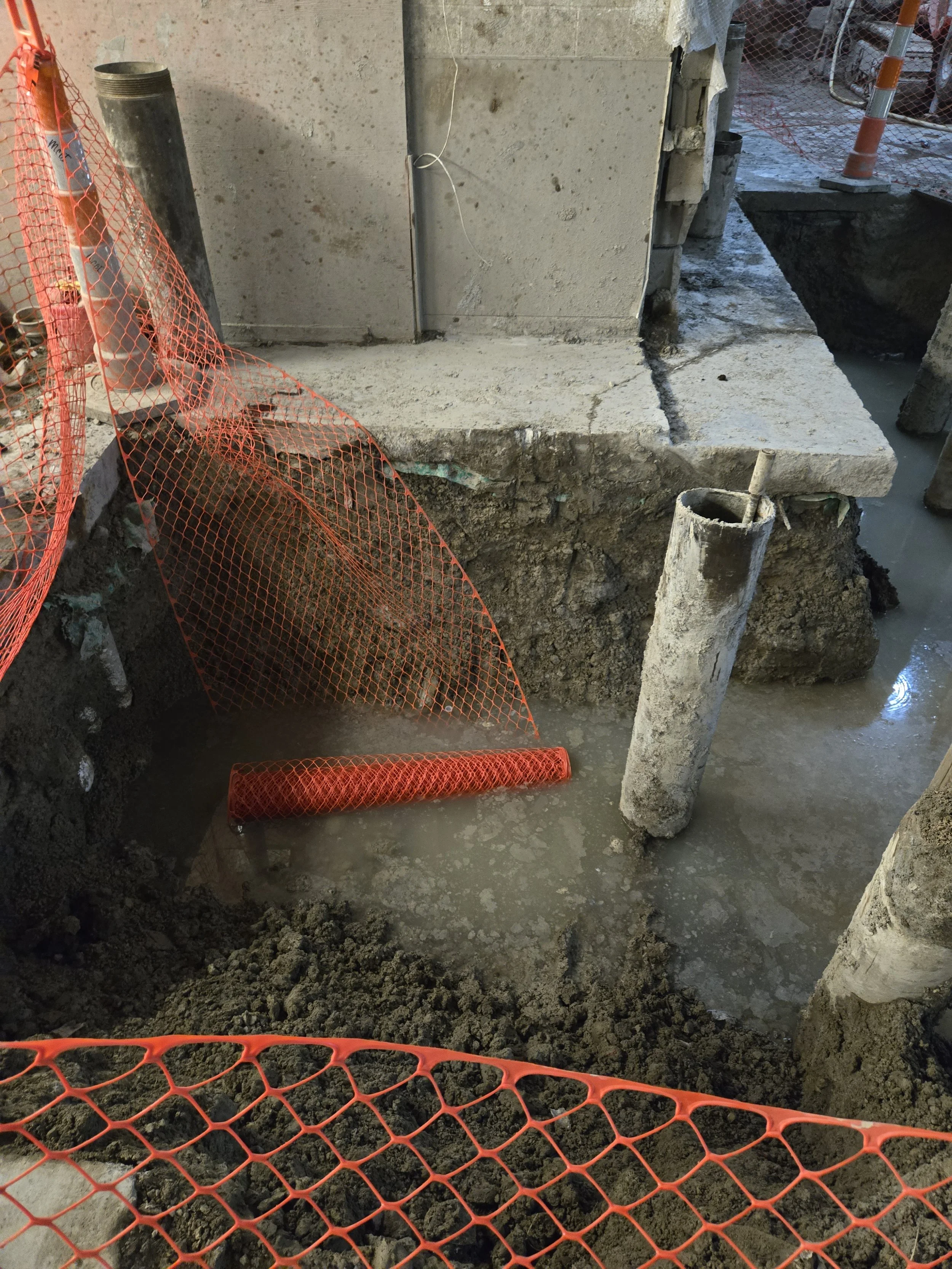

In one portion of the project, a confined approach pit was required to underpin isolated foundation elements.

This required:

  • Staged hand excavation

  • Temporary vertical supports installed incrementally

  • A grout working pad

  • Controlled board placement and retention Approach Pit Shield - Materials…

Underpinning isn’t just structural design — it’s choreography between excavation, support, and structural load transfer.

When done correctly, it feels uneventful.

That’s the goal.

Underpinning: Staged Approach Pit

Excavation occurs exactly at the face of the existing footing. Sequence is everything.

0'5'10'15'
Existing Foundation
Grout Pad
Foundation is stable on original grade.
Step 1: Pilot dig begins exactly at the footing face. High risk of sloughing.
Step 2: Controlled board placement maintains soil confinement.
Step 3: Grout pad transfers load to the new bearing level.
CRITICAL: No boards installed. Soil under footing collapsed into pit.

Shoring Stiffness vs. Foundation Settlement

Flexible systems allow soil "stress relief," causing the adjacent building to tilt toward the cut.

Adjacent Structure
Excavation Face

Final Thought

  • Temporary shoring is often removed and forgotten.

  • But during construction, it carries real risk, real load, and real responsibility.

  • When excavation occurs next to existing structures, good shoring design doesn’t just hold back soil — it protects schedule, budget, and structural integrity.

  • If you’re planning a deep excavation in a constrained environment and want to talk through options before the digging starts, that’s exactly the right time to involve a structural engineer.
